Beth El La Jolla Project Journal

Design for the ‘Aron Hakodesh sidelights for the new chapel at Congregation Beth El La Jolla This Project Journal tracks the fabrication of the two stained glass panels, including the crating, delivery and installation at the site.

pillar color.png

January 3, 2026

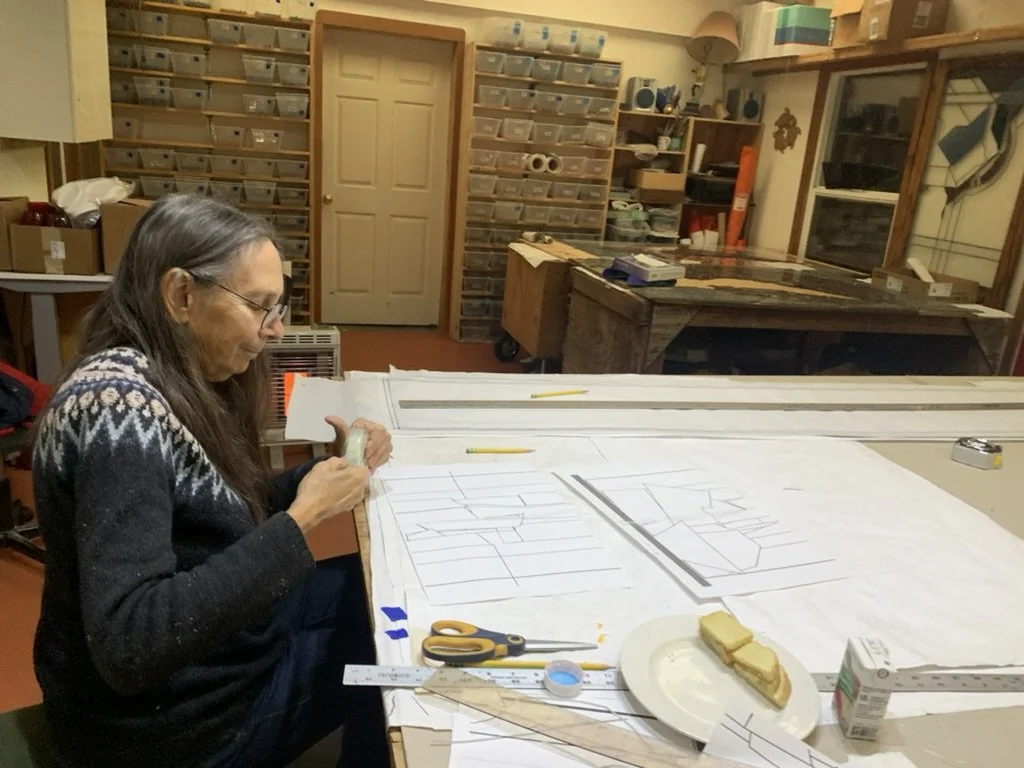

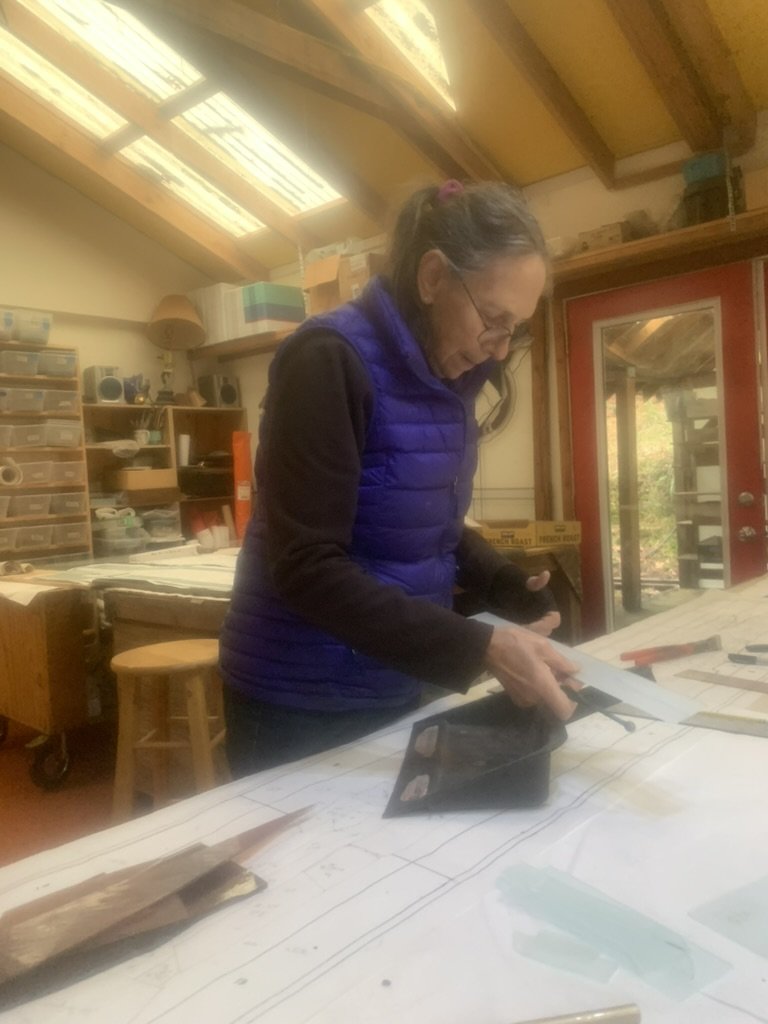

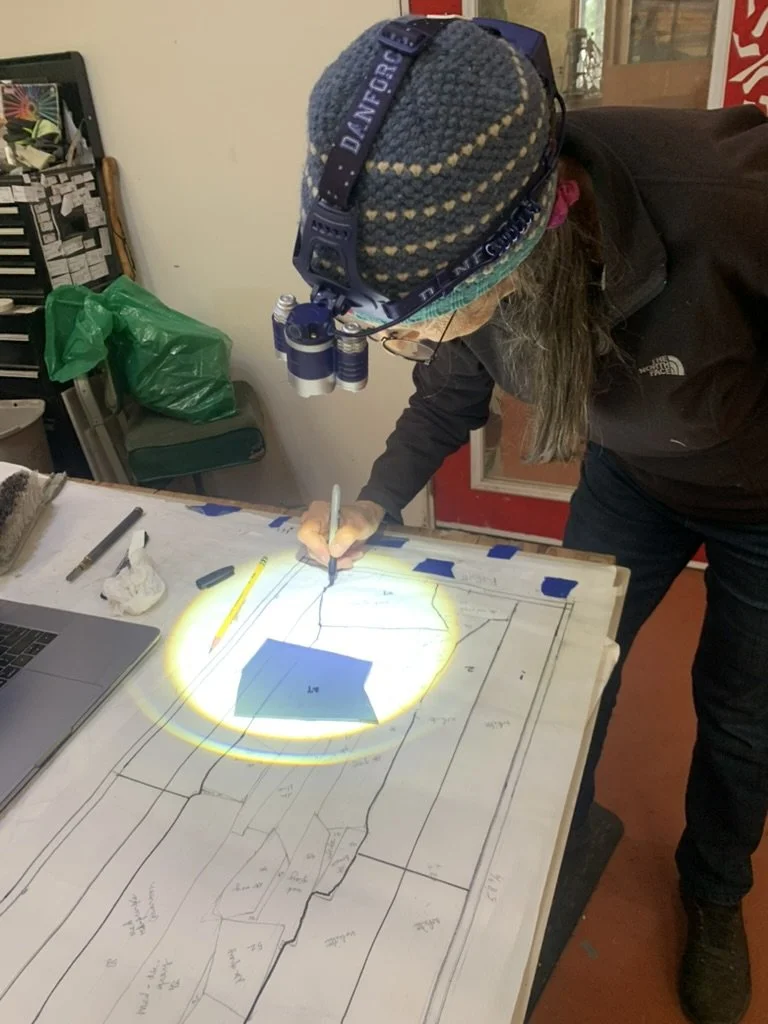

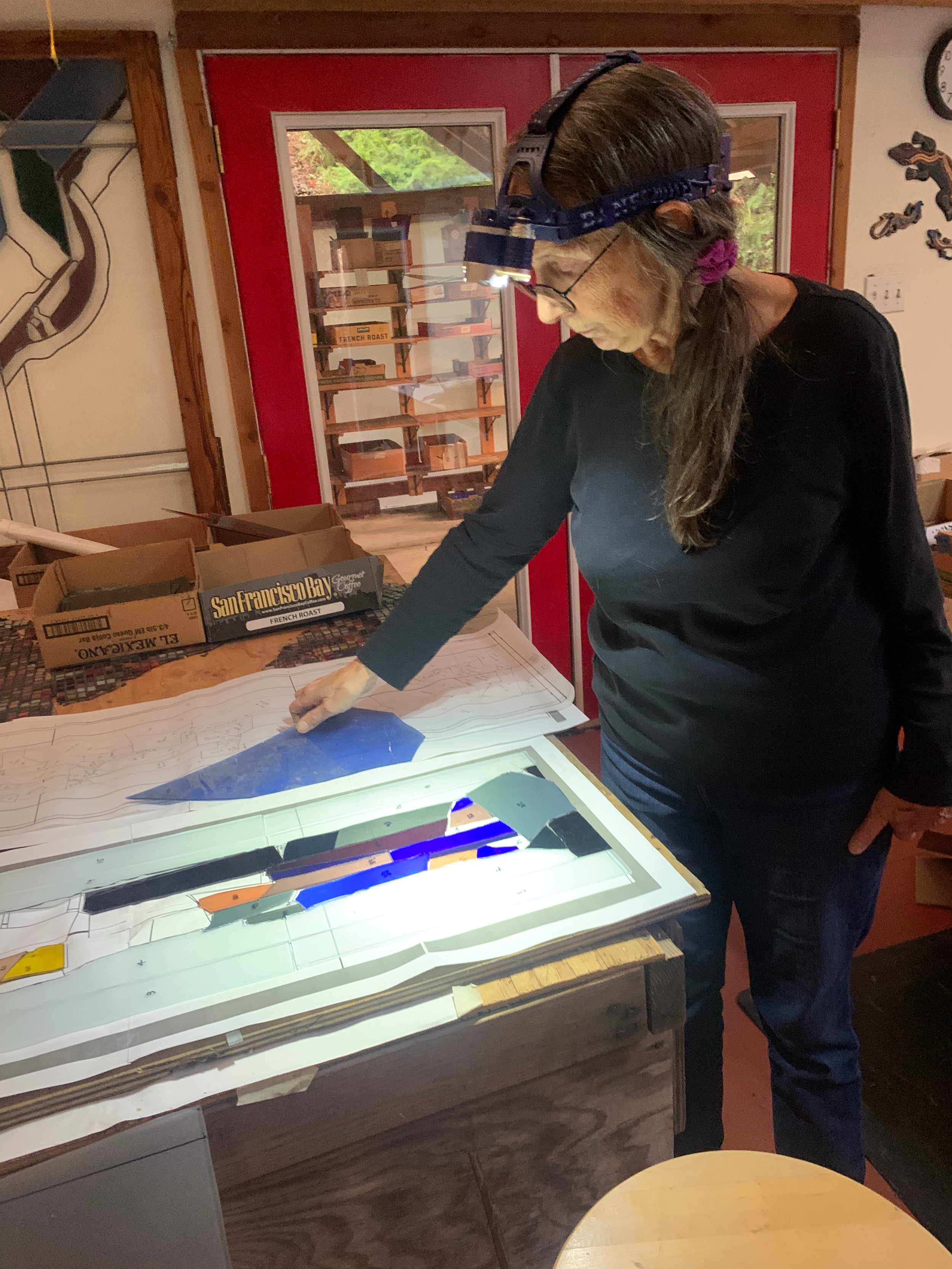

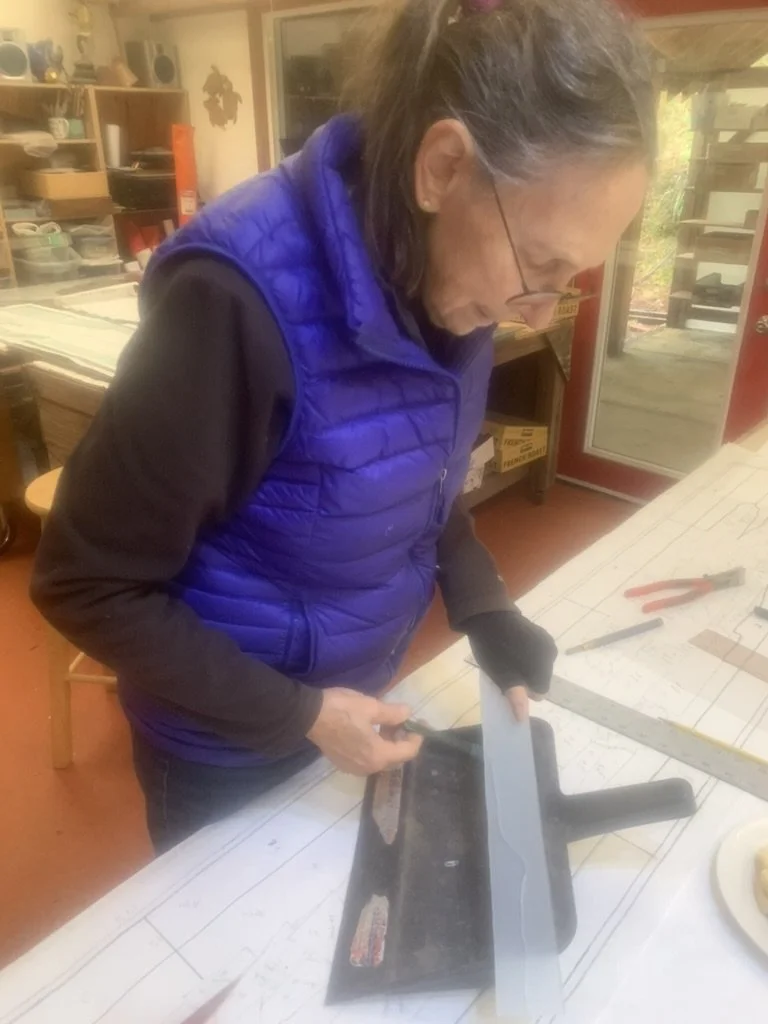

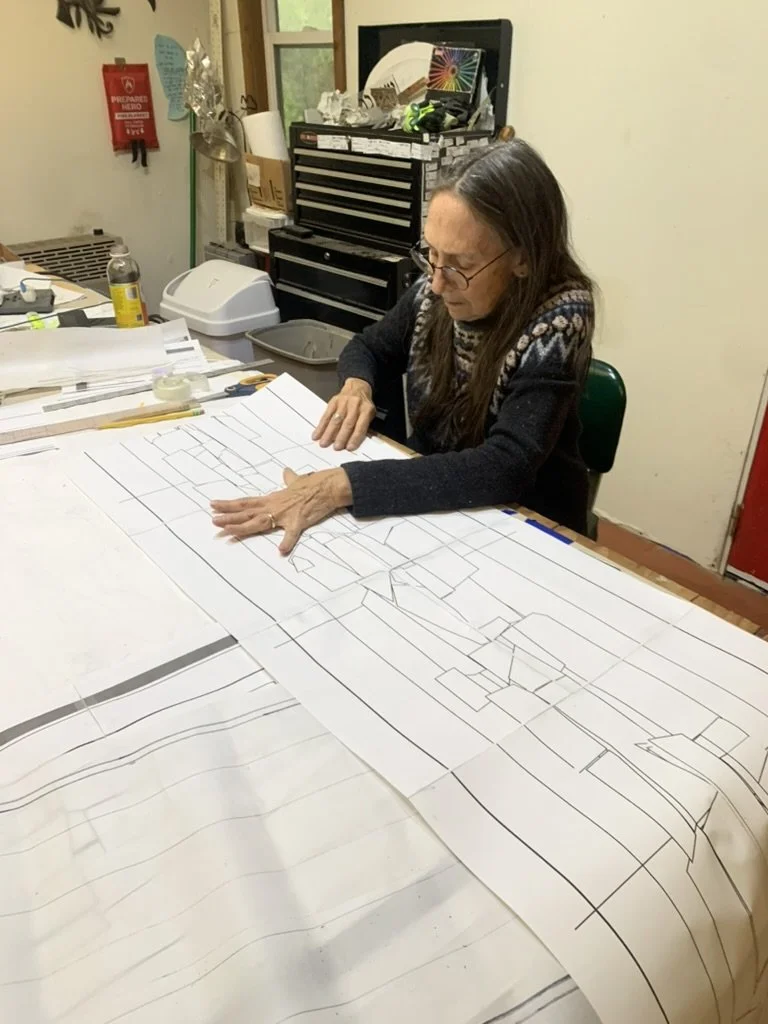

Michelle works on the full-size patterns for the windows.

January 6, 2026

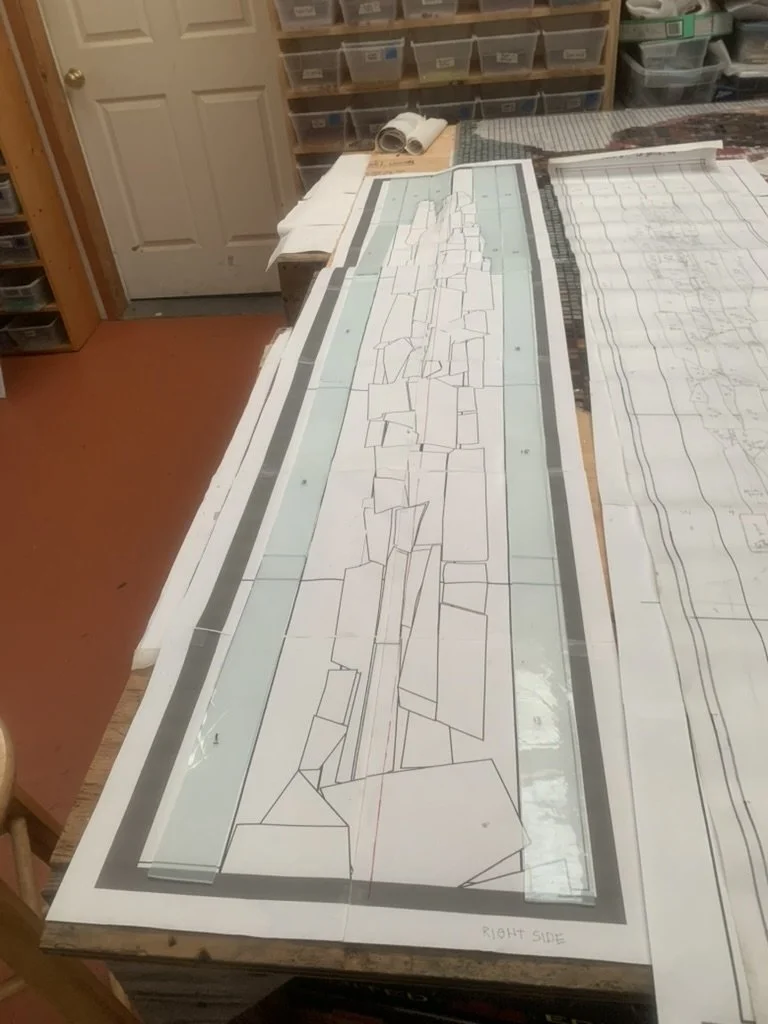

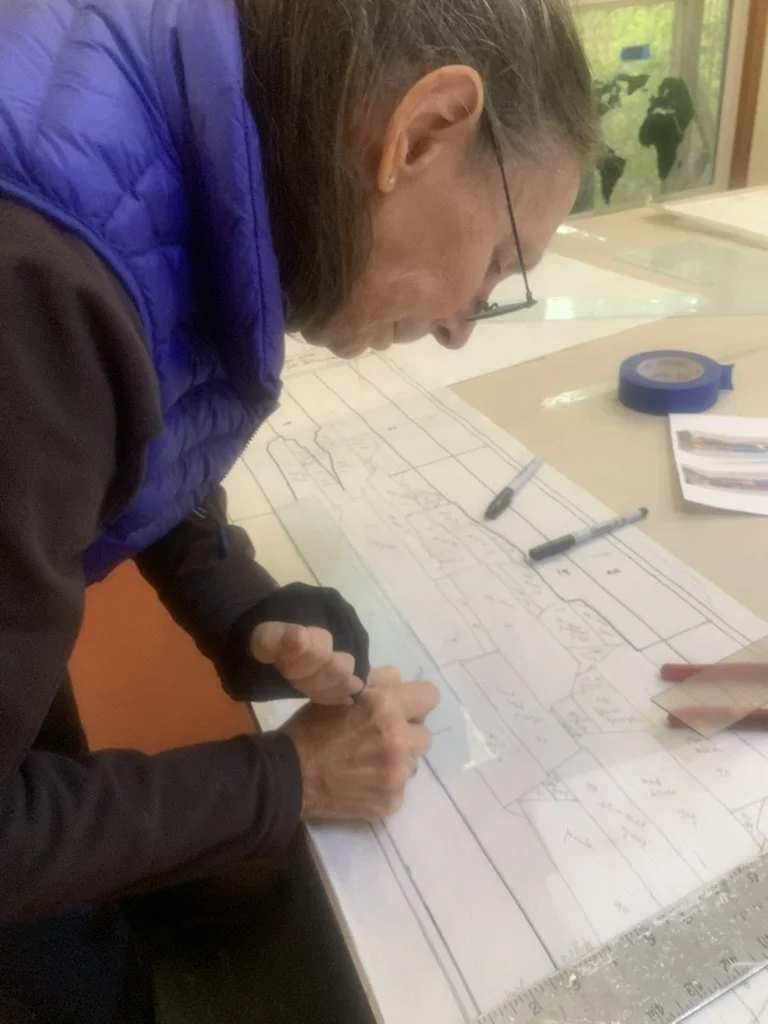

Michee begins cutting glass on the patterns confirmed in size at 13 ¼ x 73 1/4.

January 7, 2026

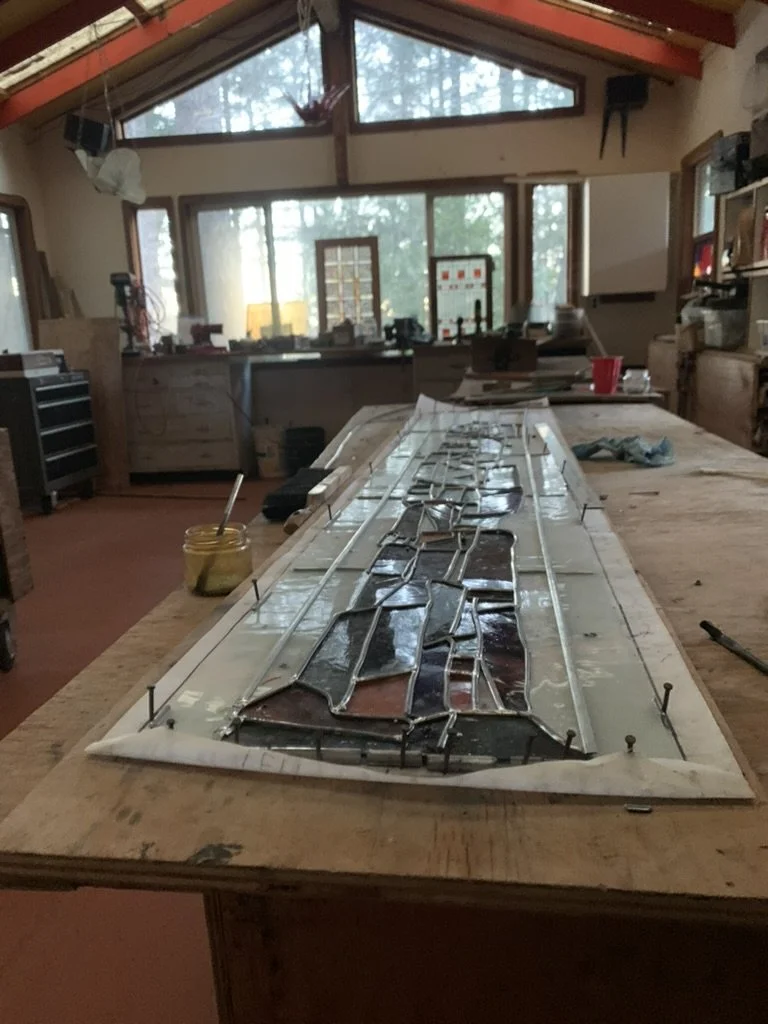

Glass cutting continues

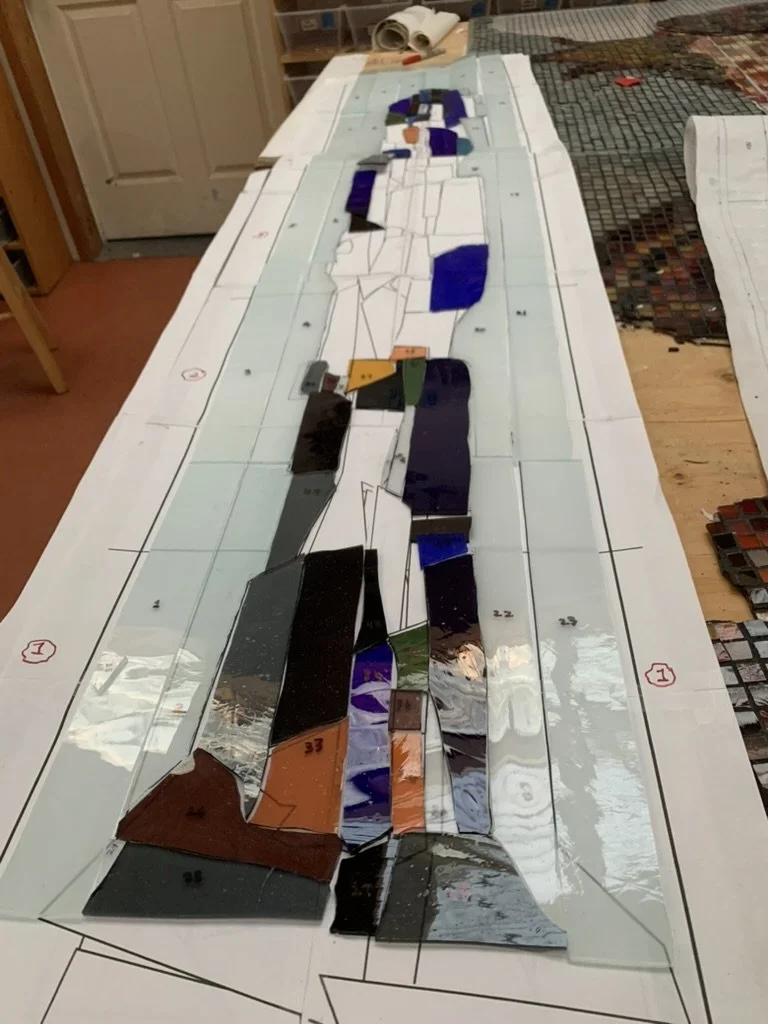

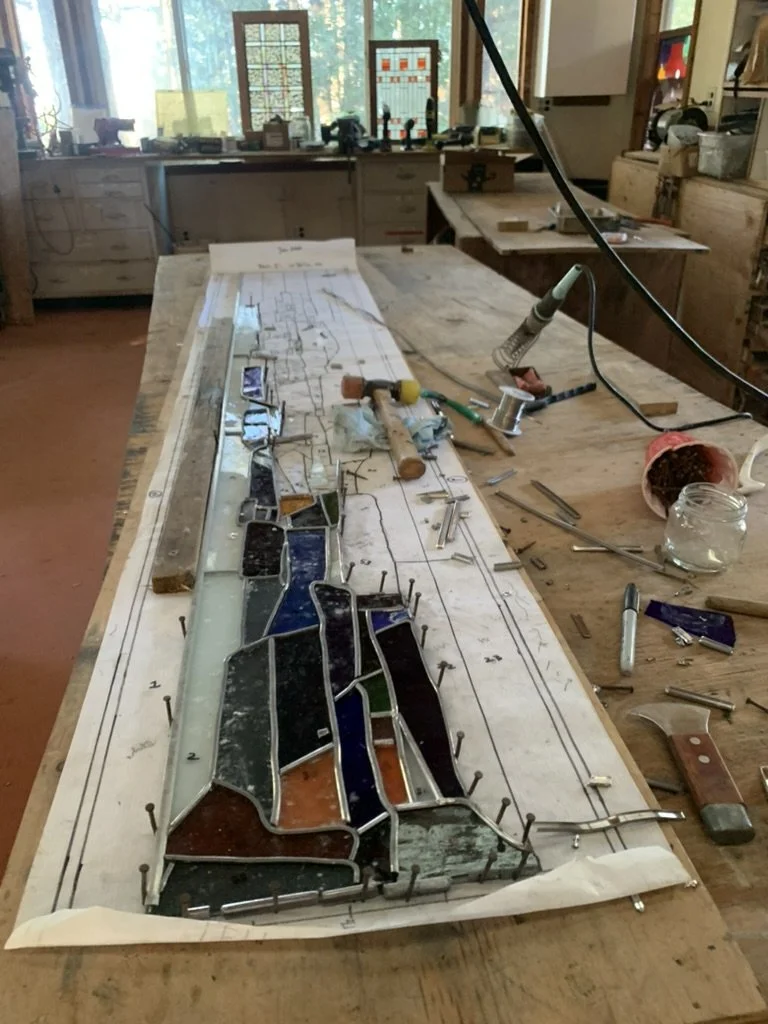

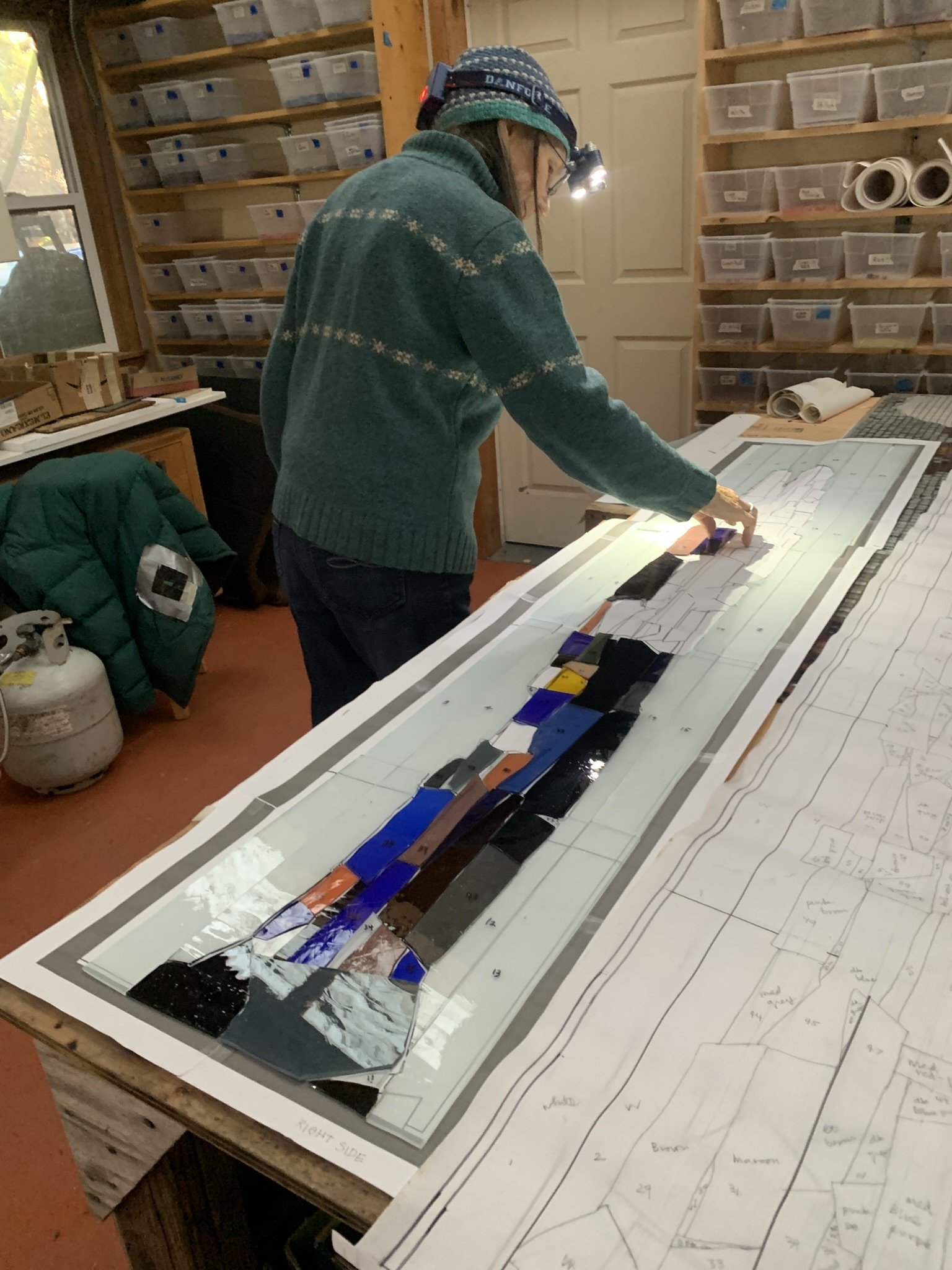

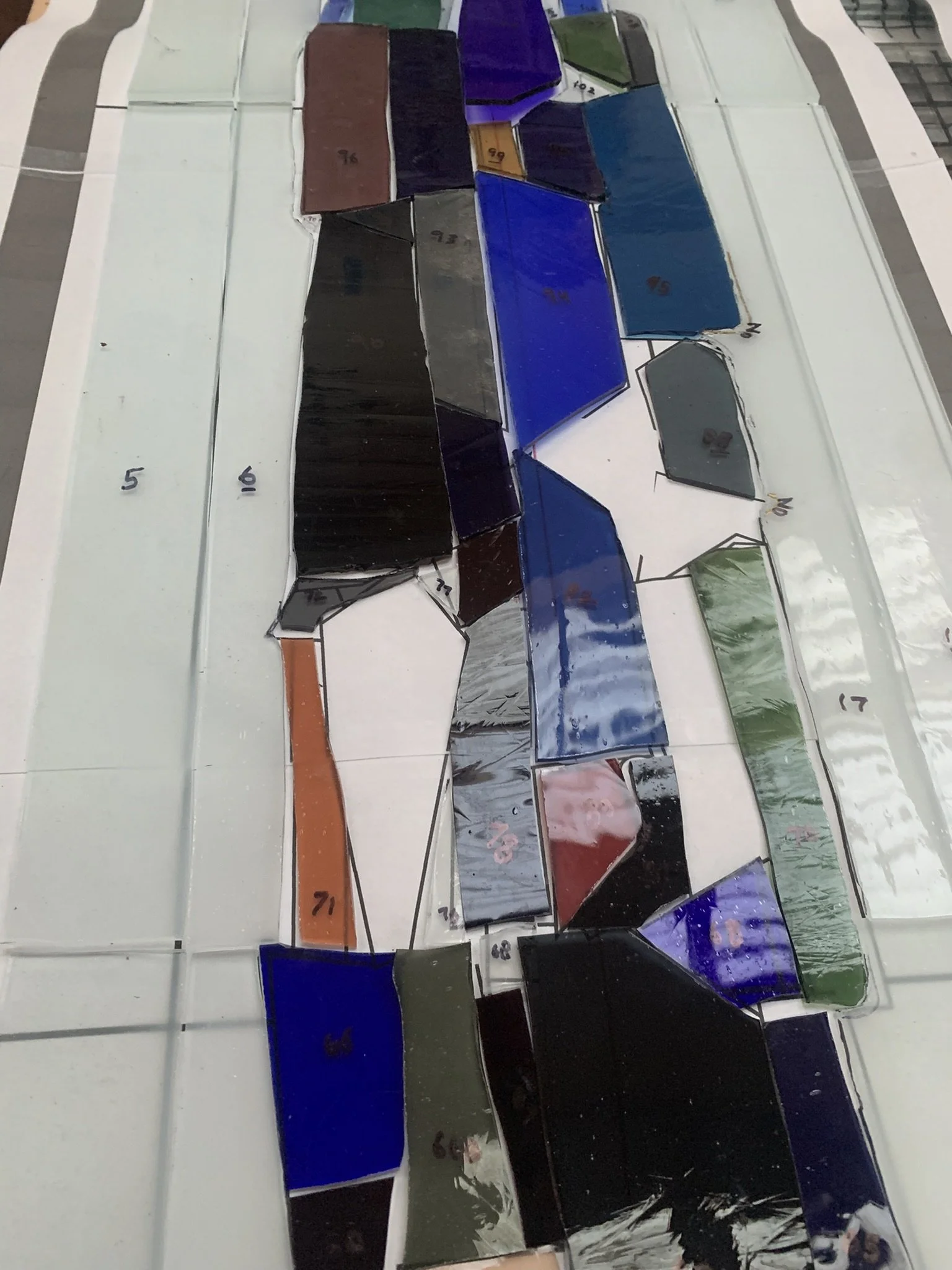

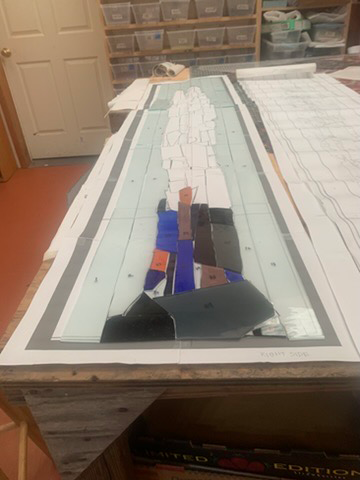

lay out piecfes.png

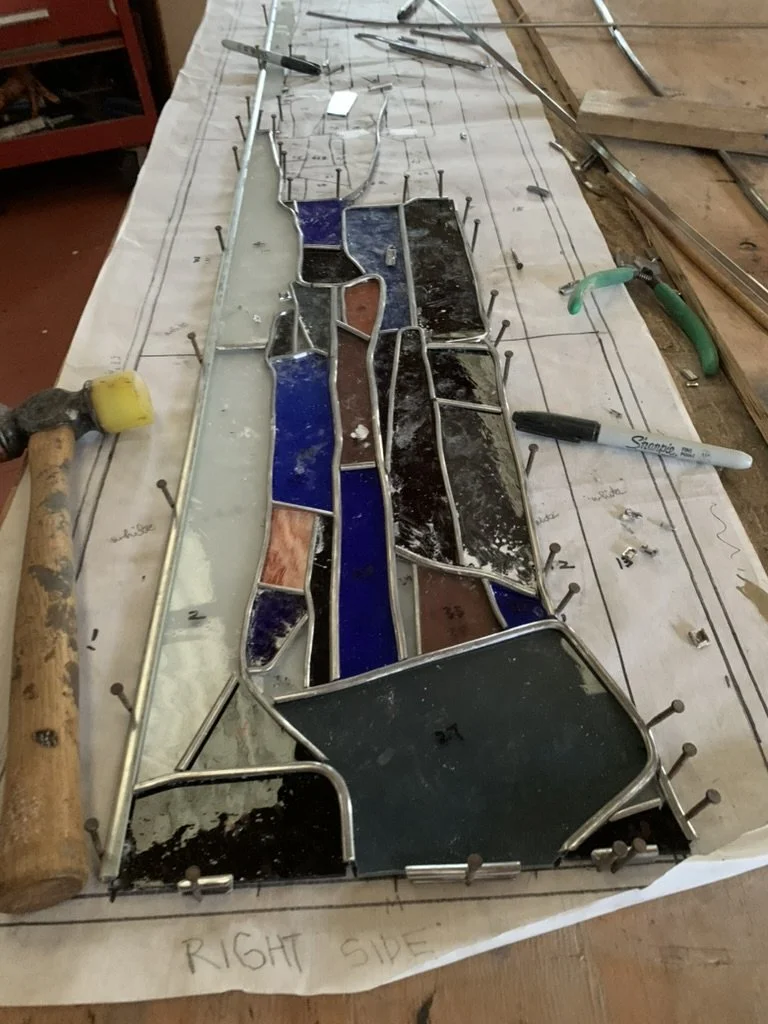

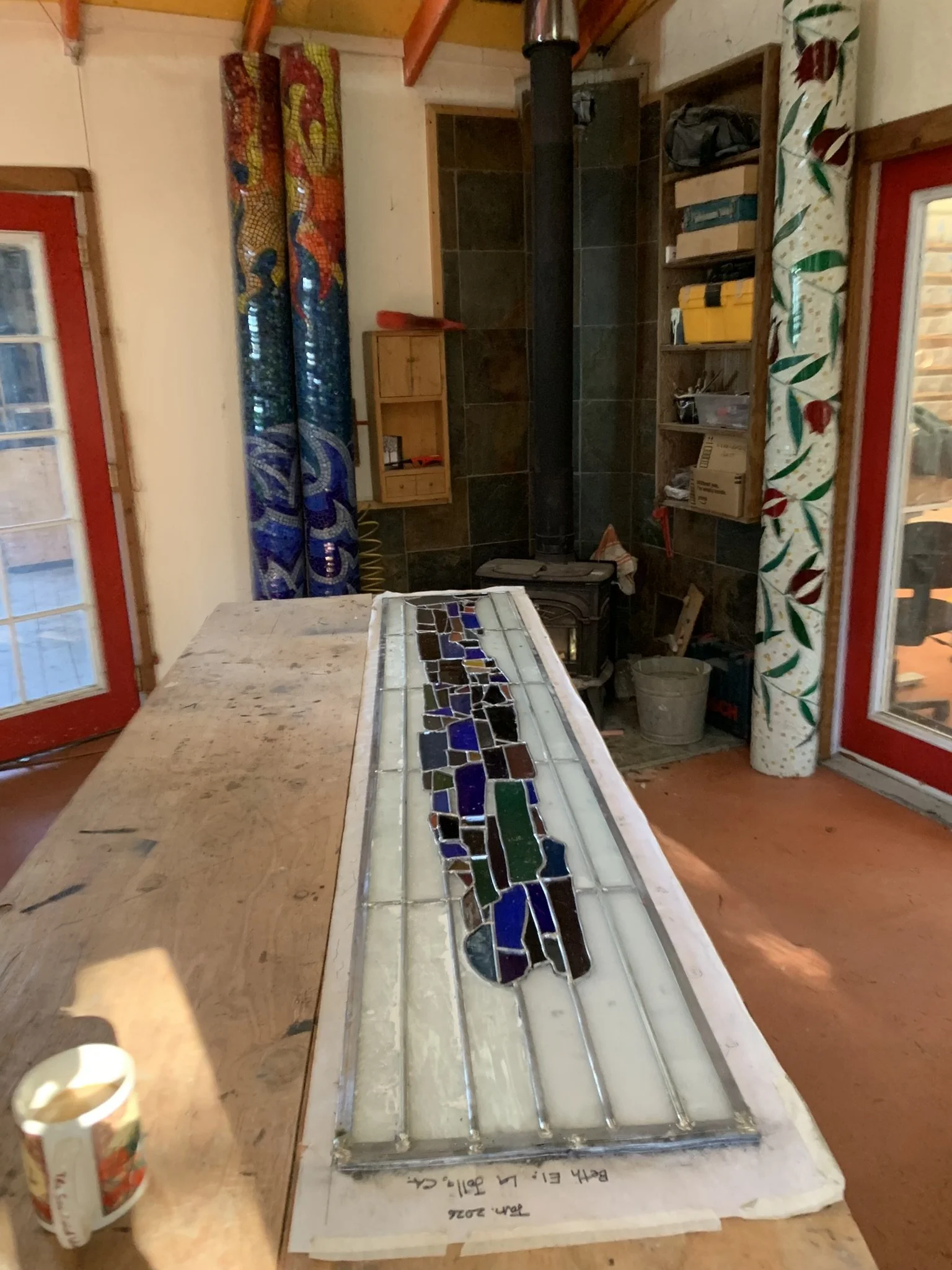

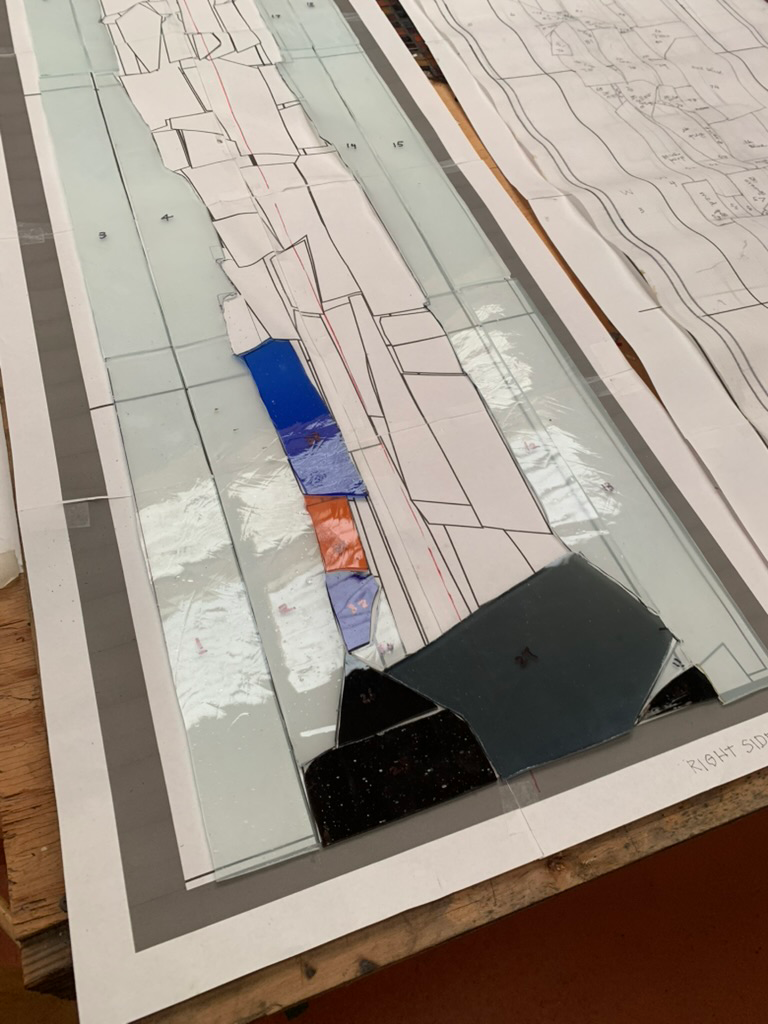

layout cs1.png

January 8, 2026

Glass cutting continues.

January 10, 2026

Mechelle completes cutting the glass for the first panel.

January 14, 2026

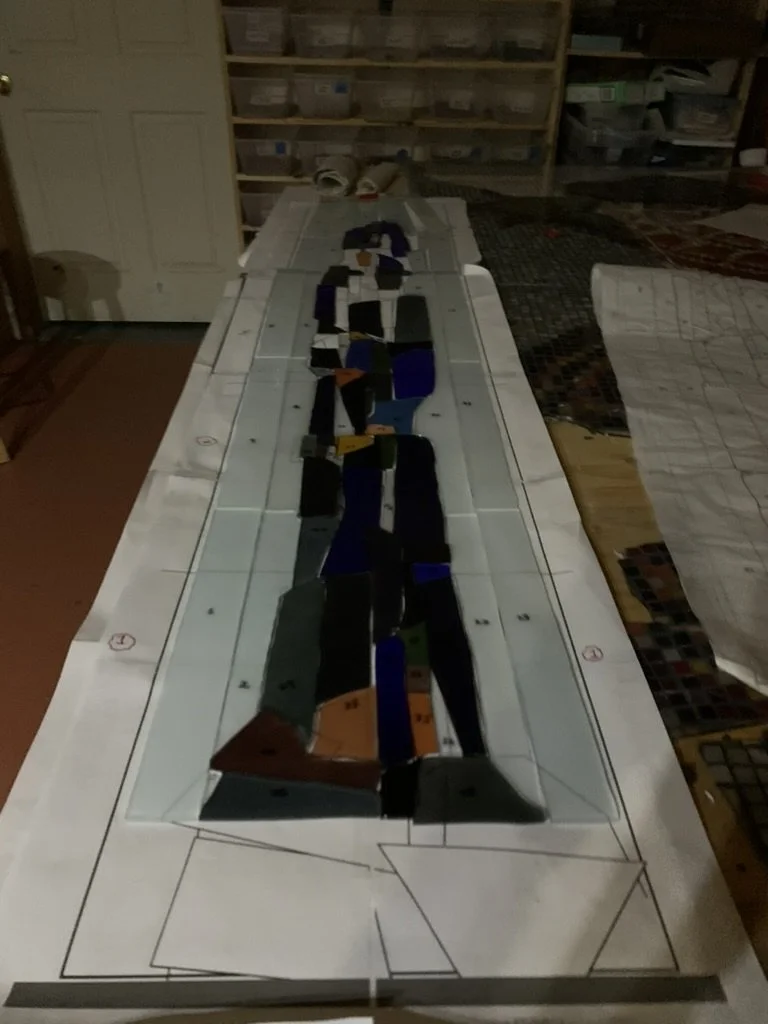

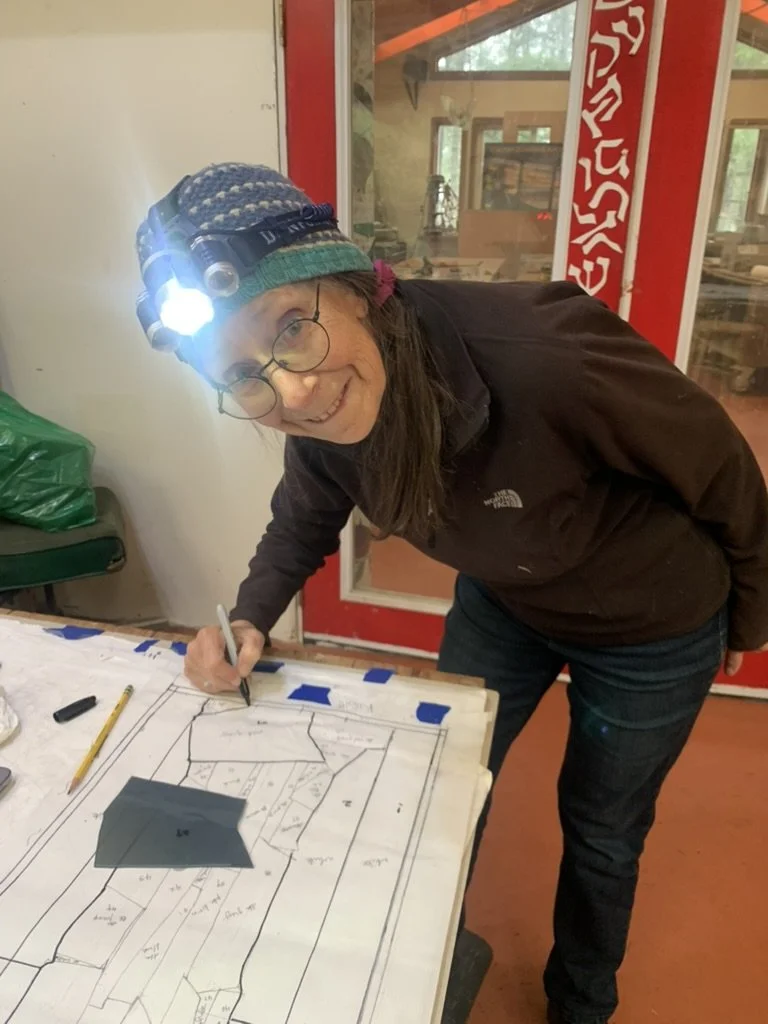

Assembly of first panel begins. Cutting begins on second panel.

January 15, 2026

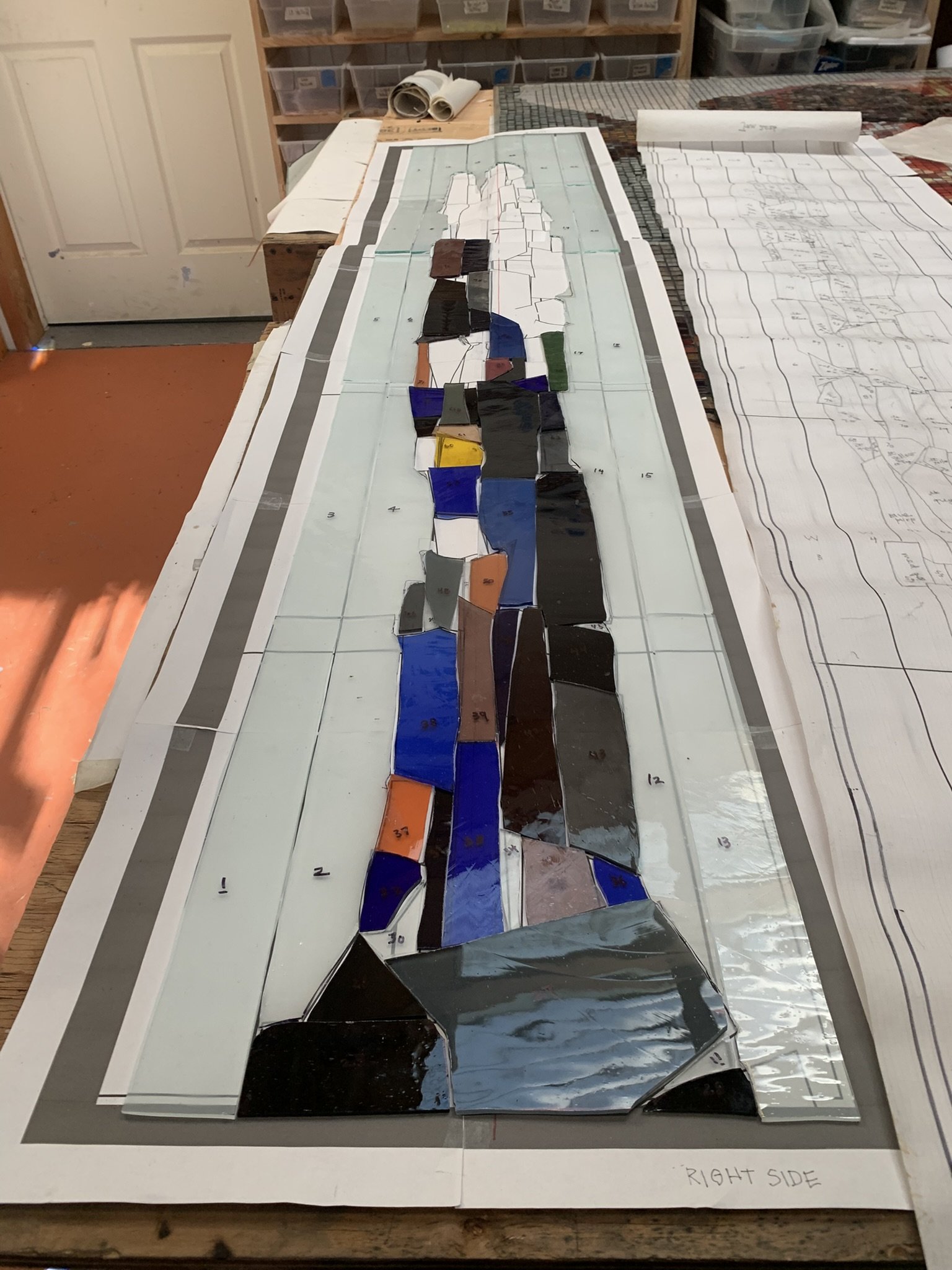

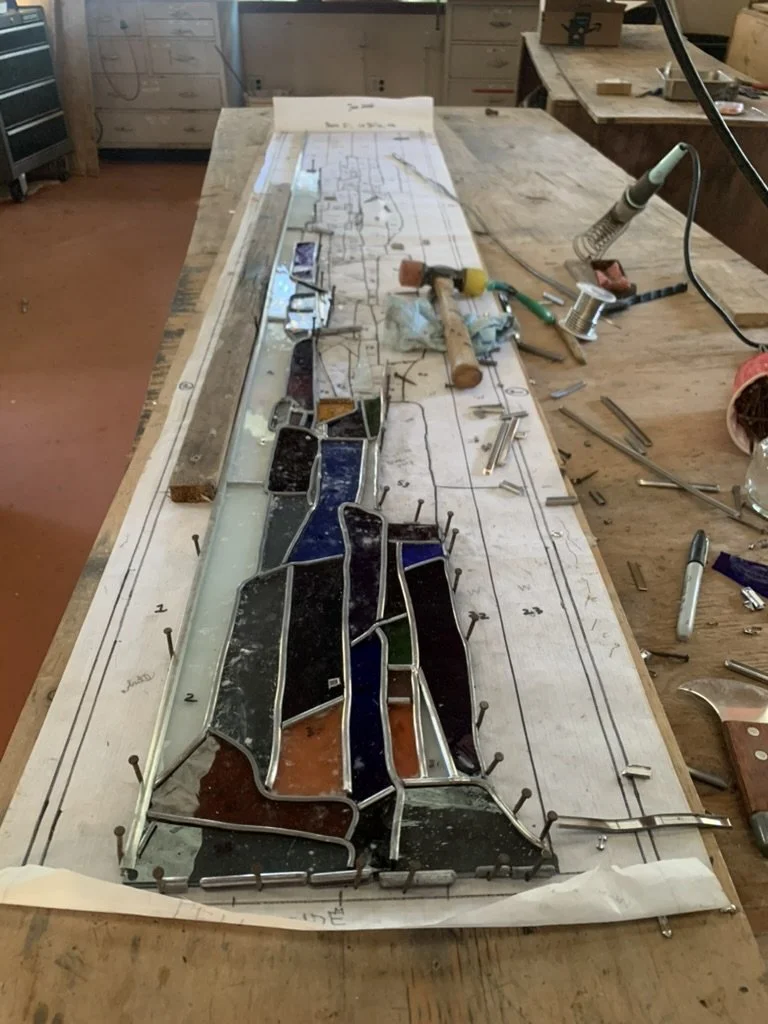

David complete the assembly of he first panek abd cements the first side. Michelle ontinues cutting on panel #2.

January 16, 2026

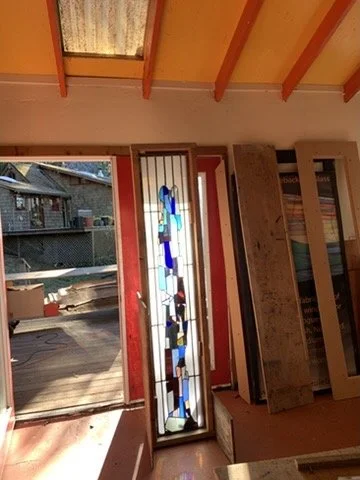

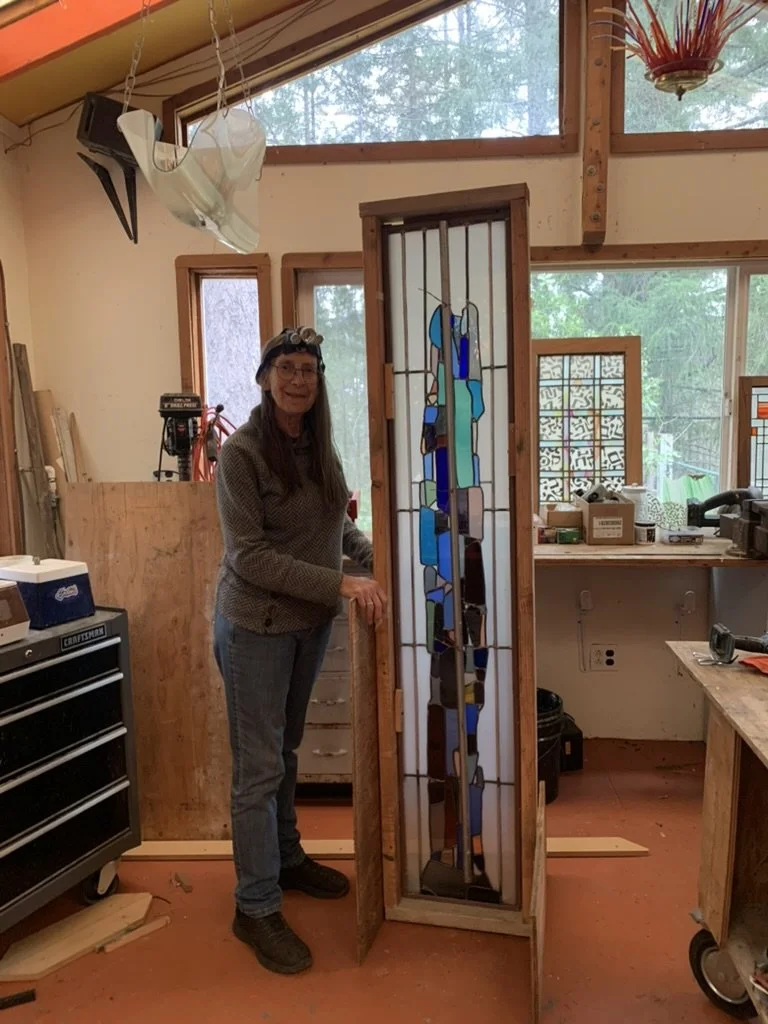

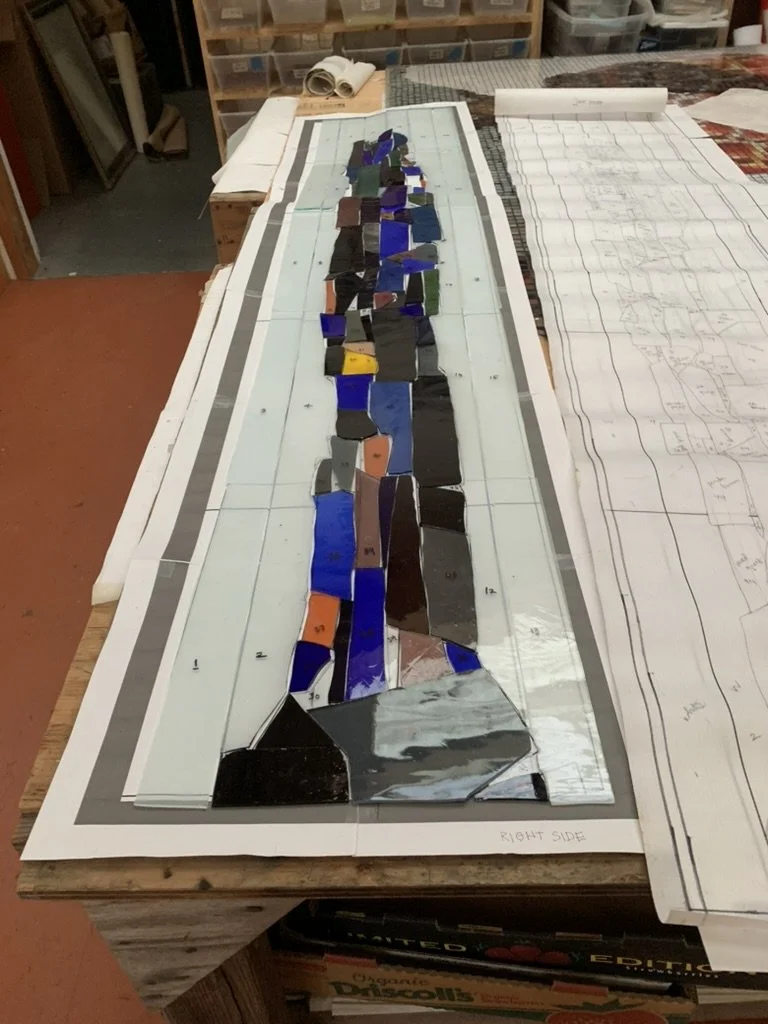

First panel is ready for final cleaning, crating and delivery while Michelle continues cutting glass for the second panel.

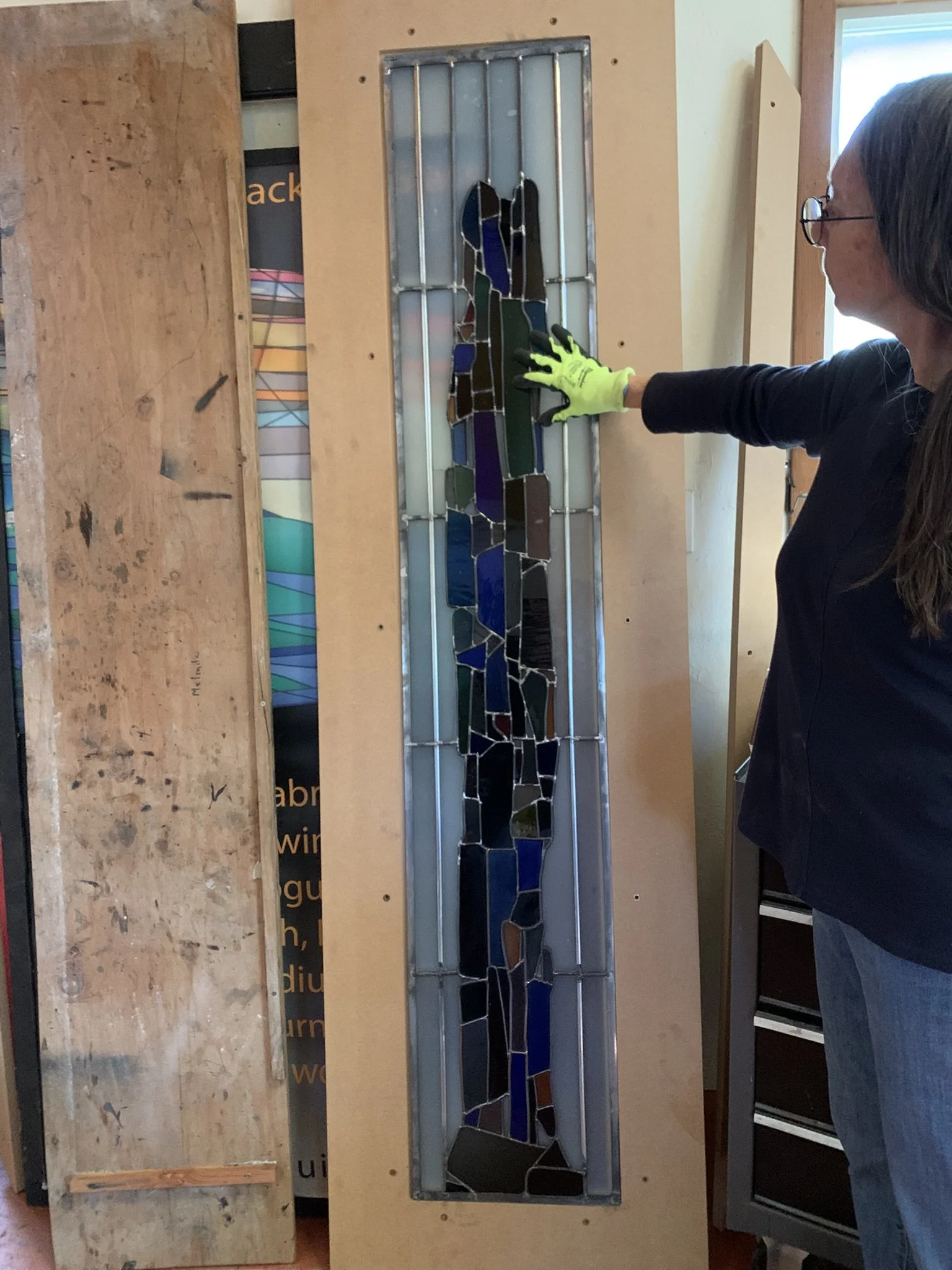

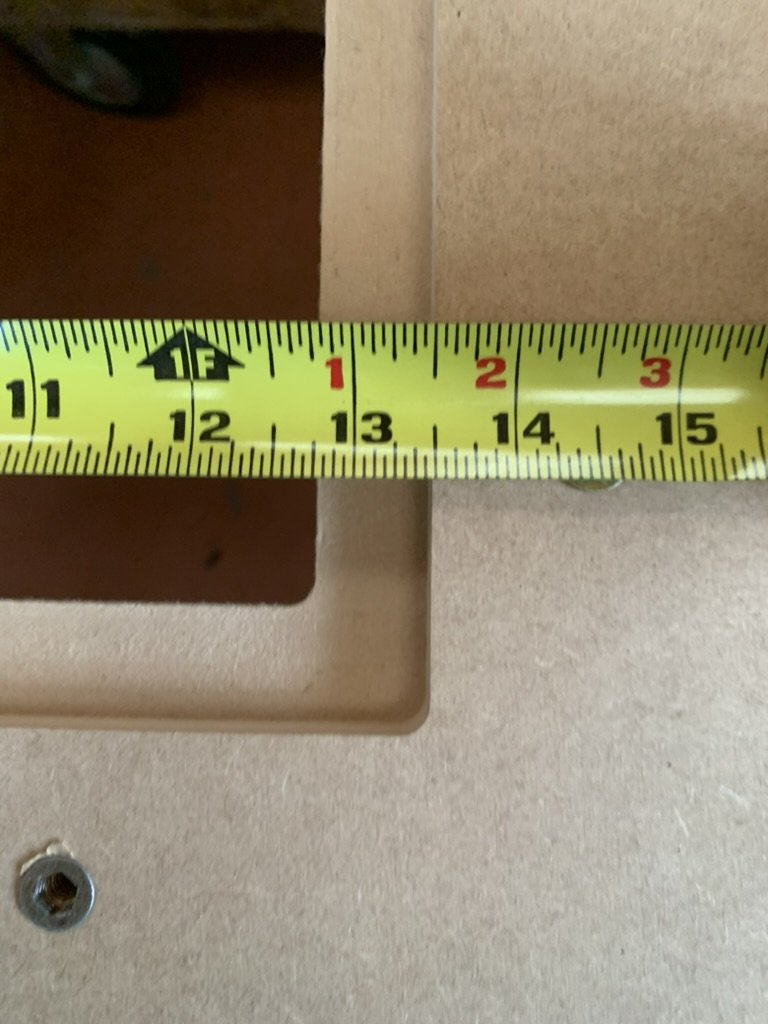

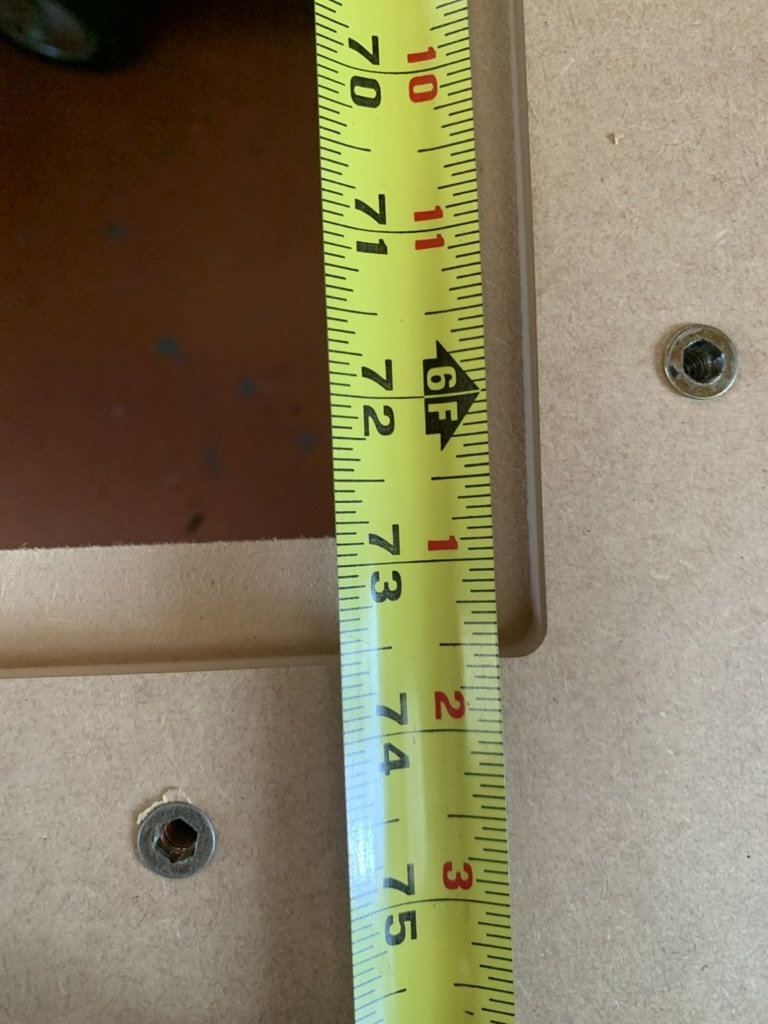

 Checking the size of the window to make sure it fits into the frame

Checking the size of the window to make sure it fits into the frame

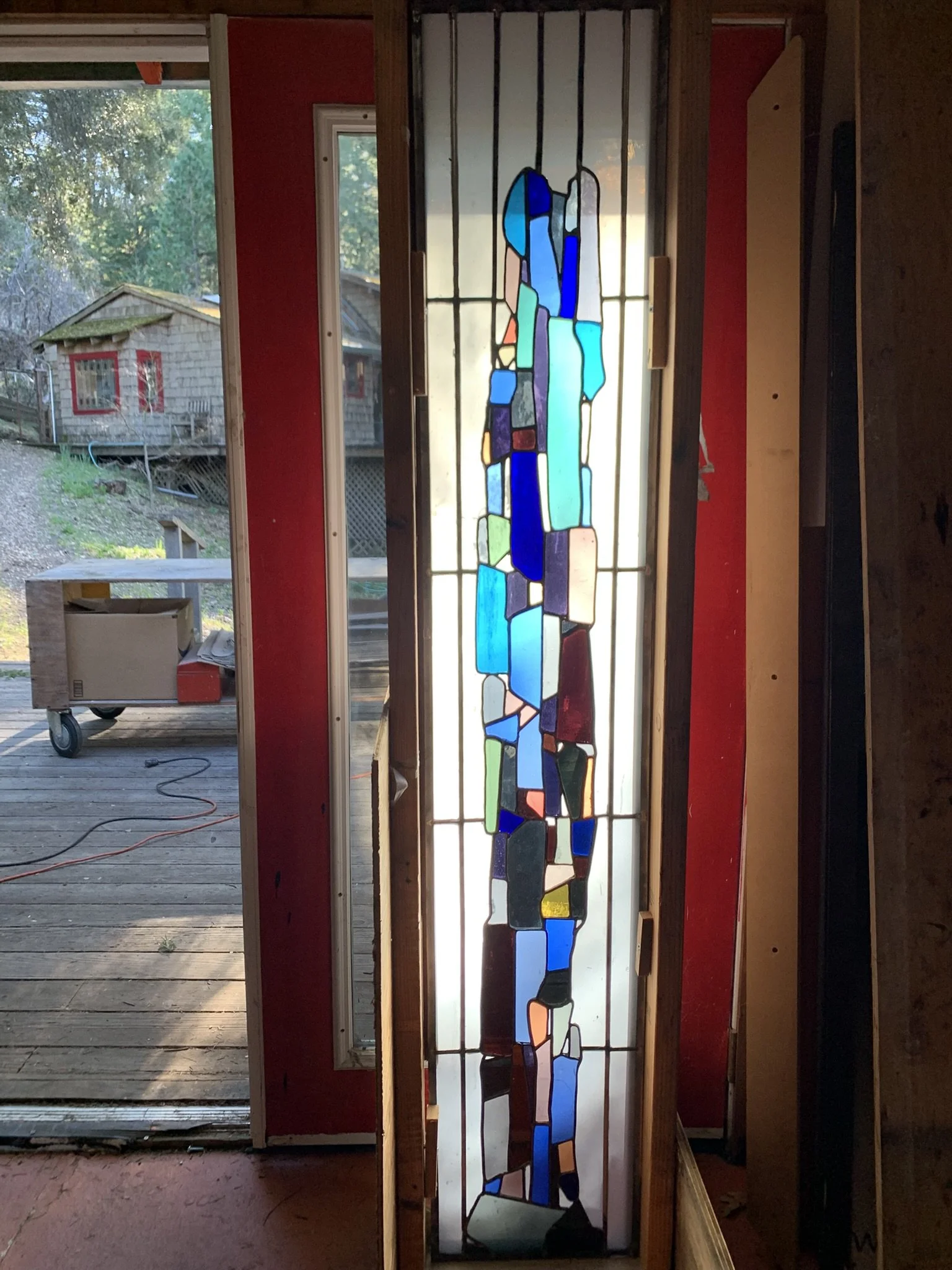

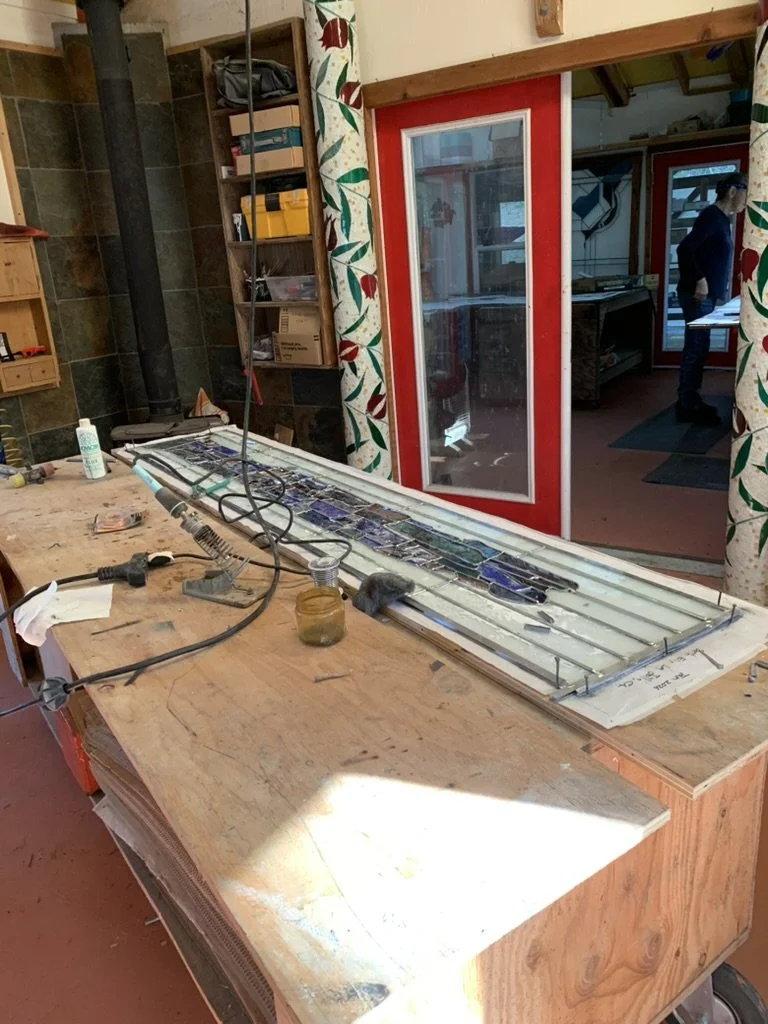

 The first panel stands in its crate ready for final cleaning

The first panel stands in its crate ready for final cleaning

 Michelle cutting pieces for the second panel.

Michelle cutting pieces for the second panel.

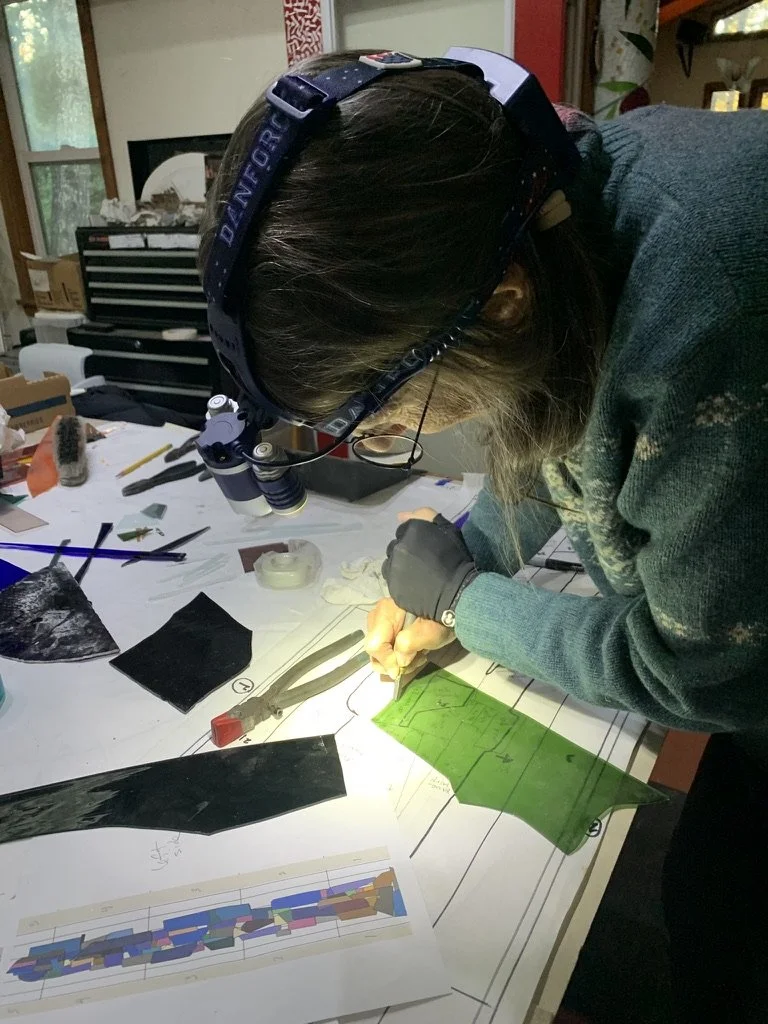

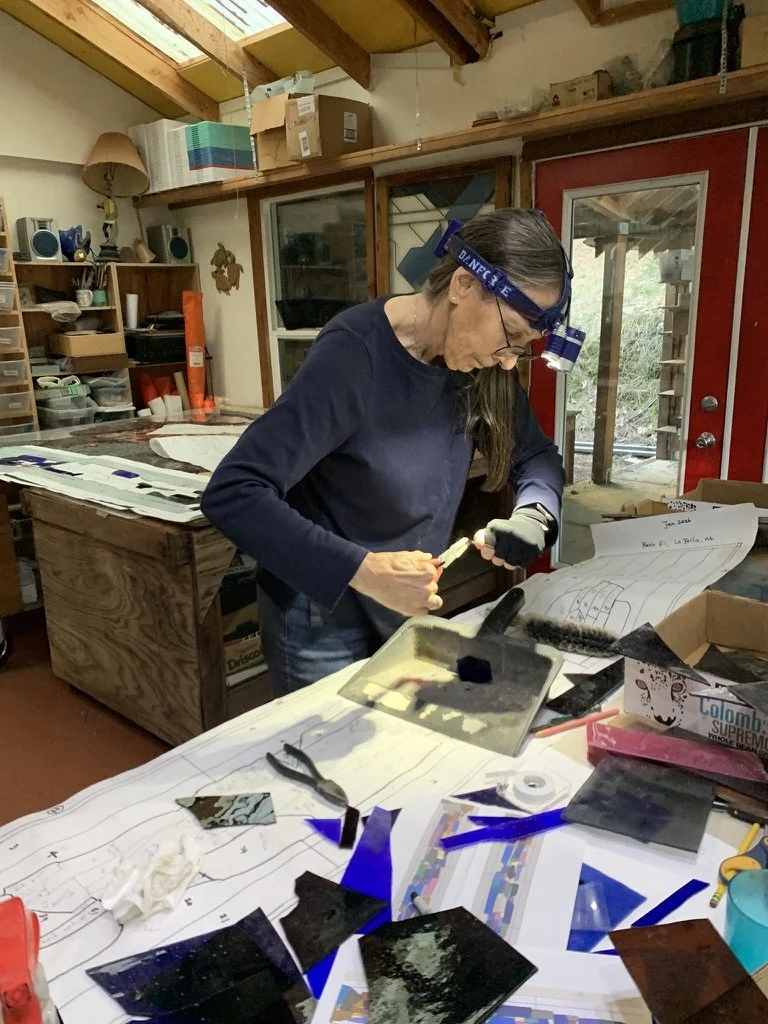

 David works on the grinder fitting pieces during the assembly

David works on the grinder fitting pieces during the assembly

January 17, 2026

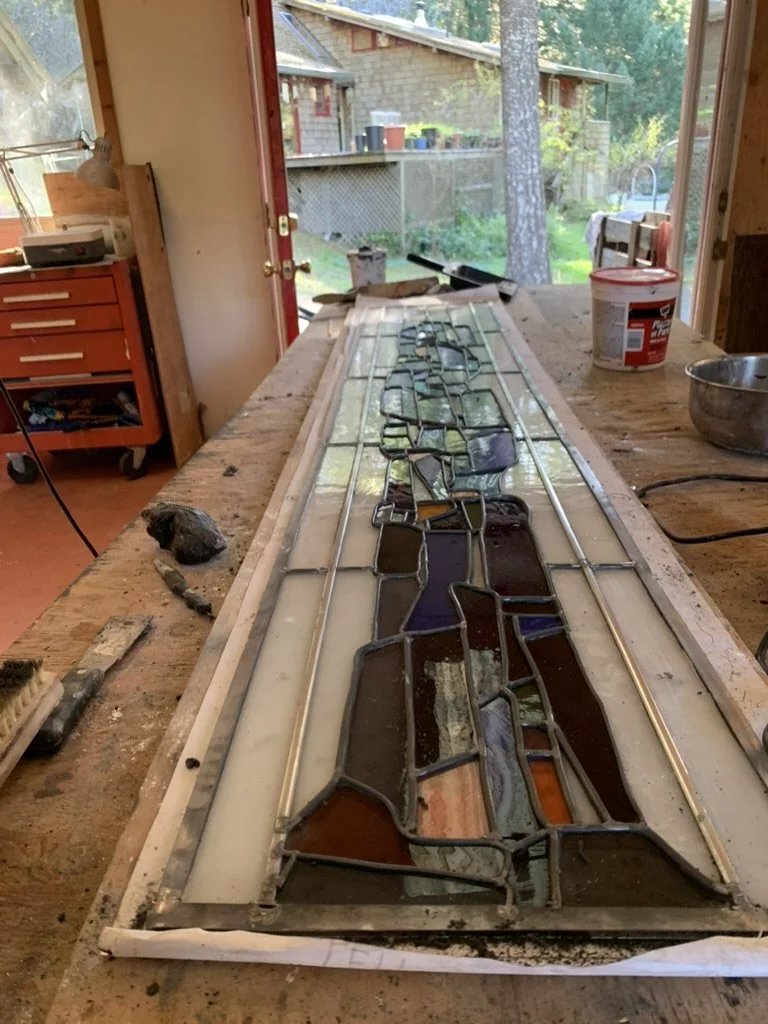

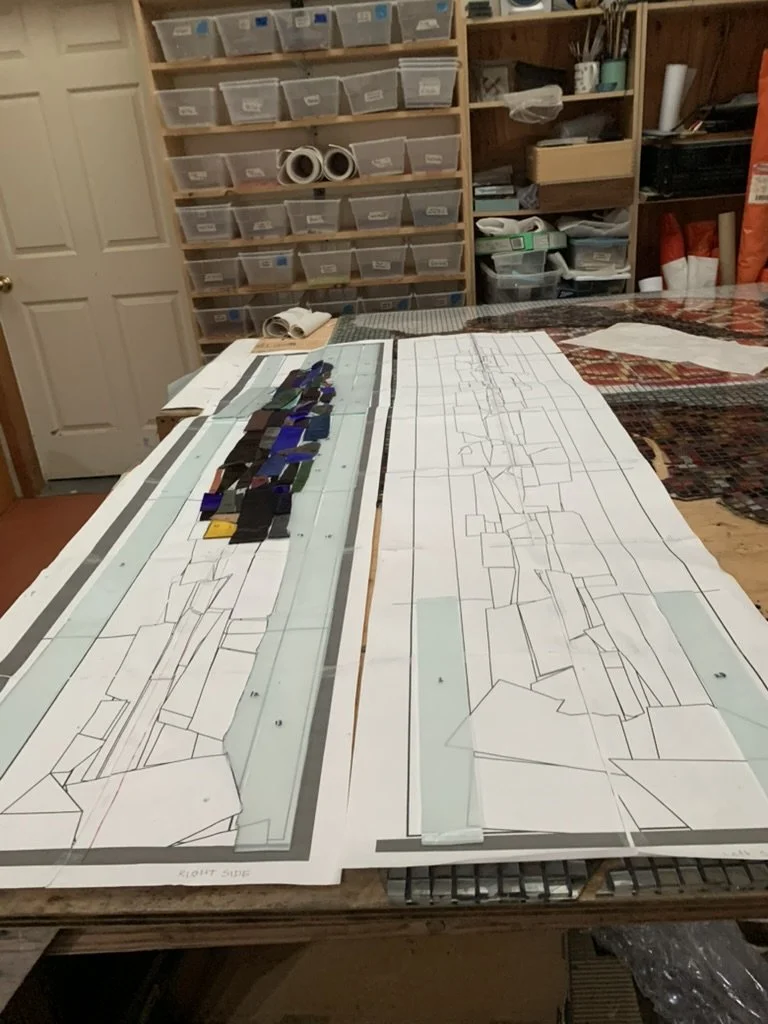

First panel is completed. Michelle continues cutting glass for the second panel.

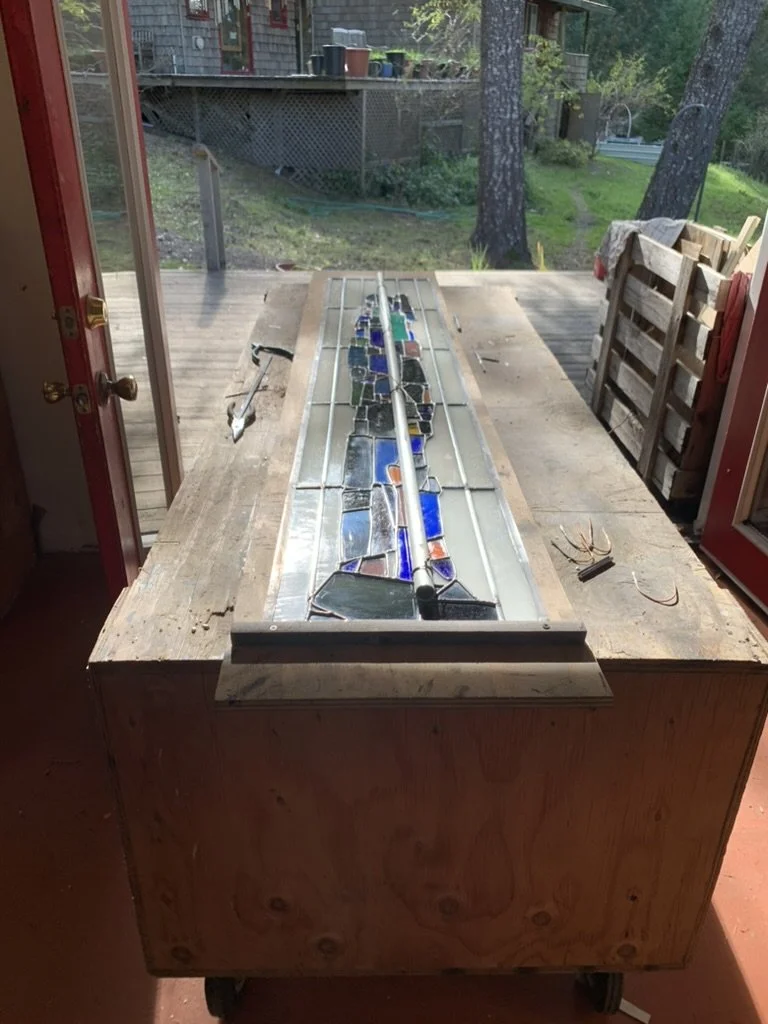

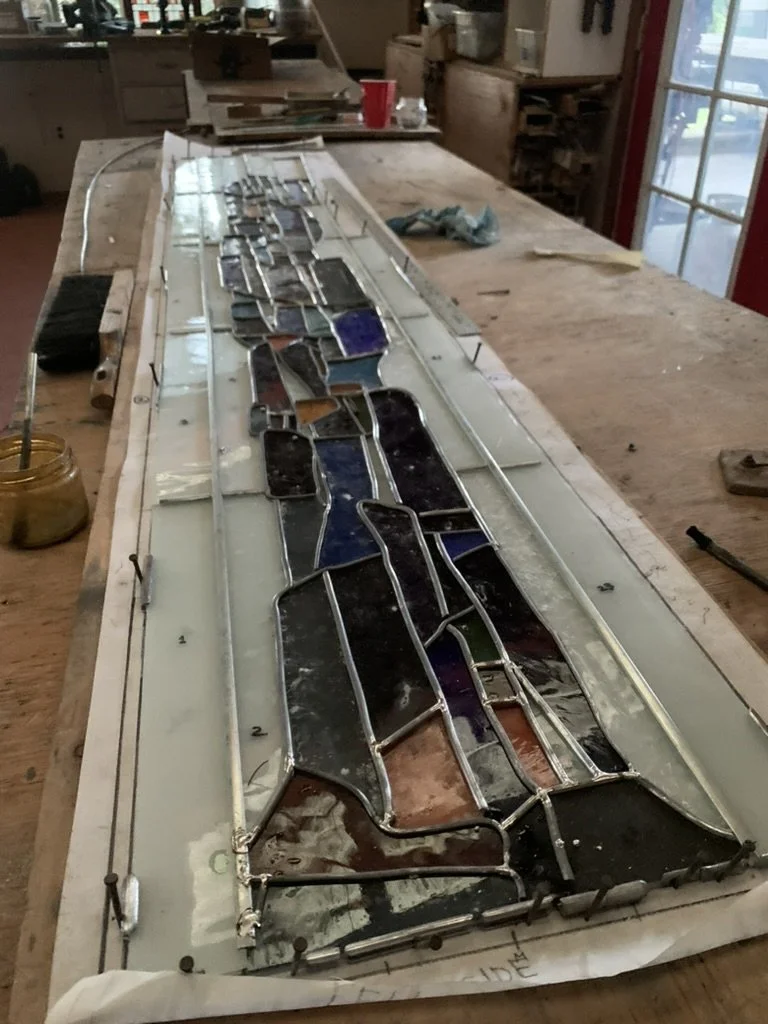

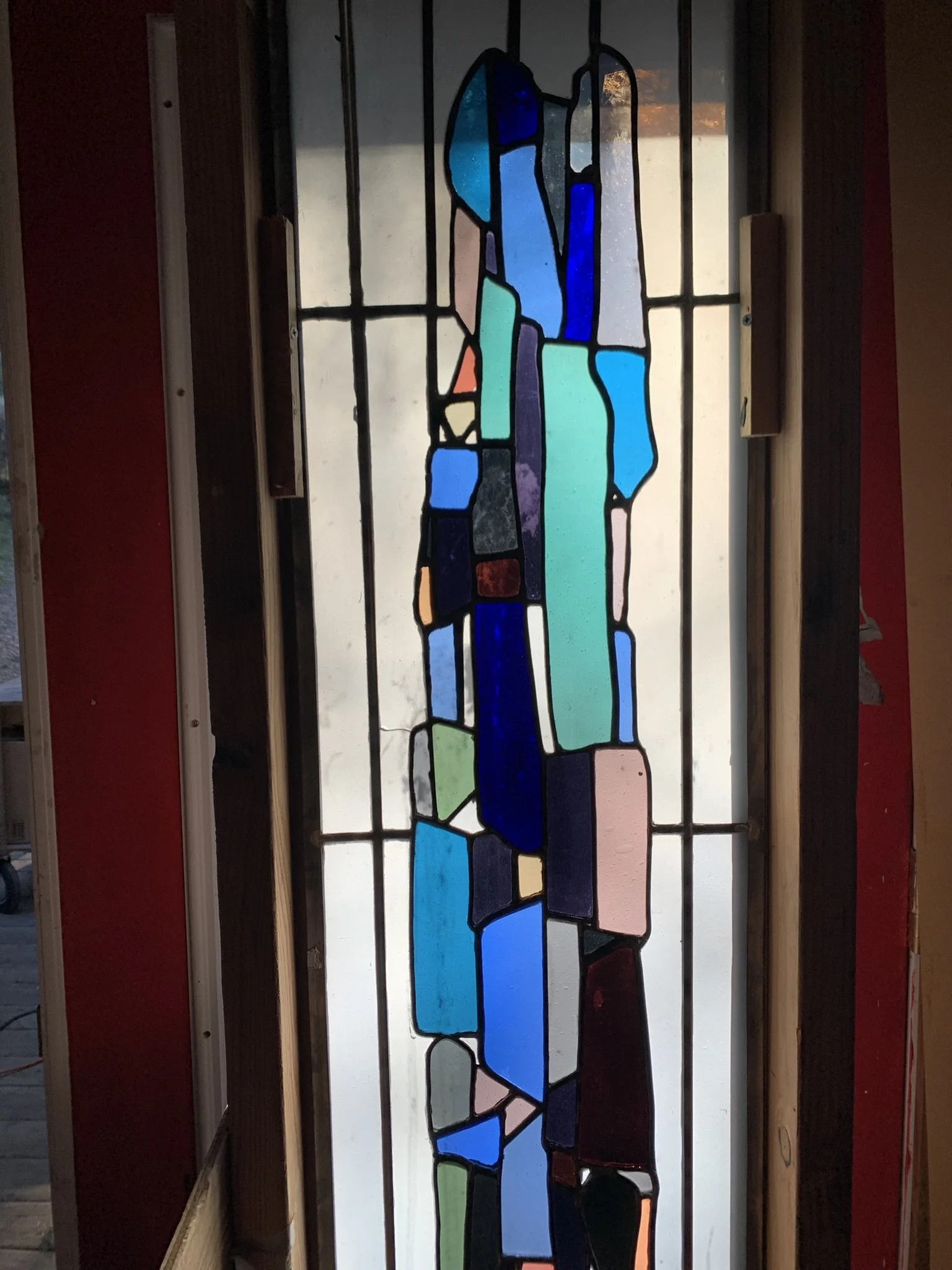

 The first panel with temporary stiffener attached for delivery and installation

The first panel with temporary stiffener attached for delivery and installation

January 20, 2026

Cutting glass continues on the second panel

January 21, 2026

Michelle completes cutting the glass for the second panel. David cleans and crates the first panel,.

January 22, 2026

Significant progress on assembly of the second panel

January 23, 2026

Assembly of second panel and cementing of the first side completed.

January 28, 2026

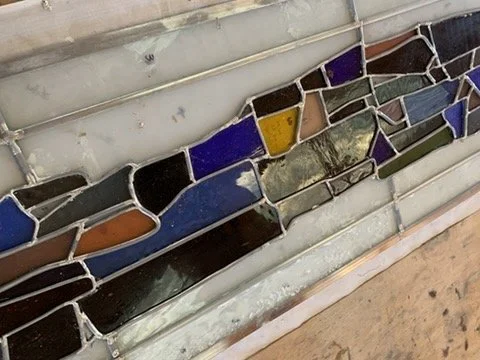

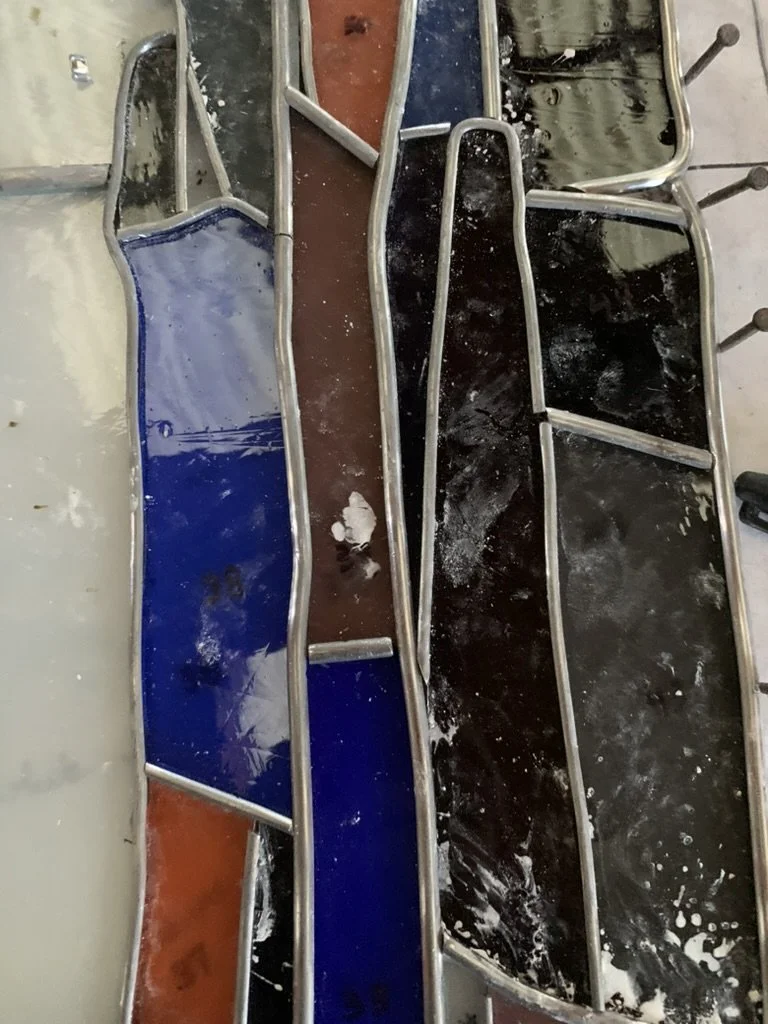

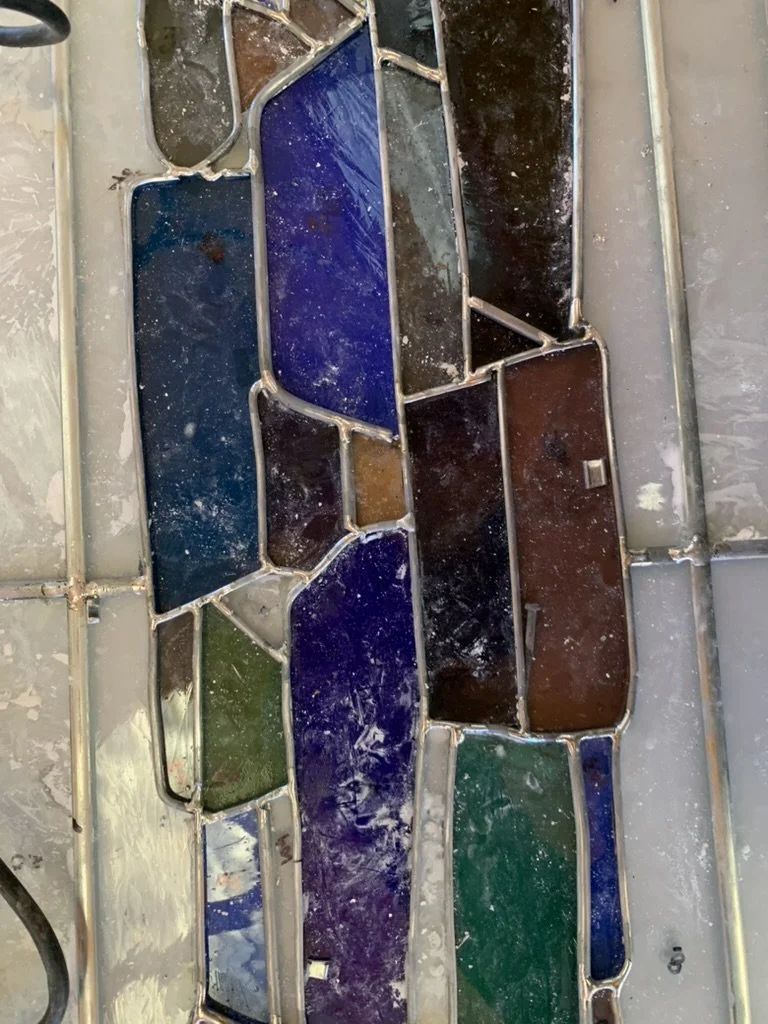

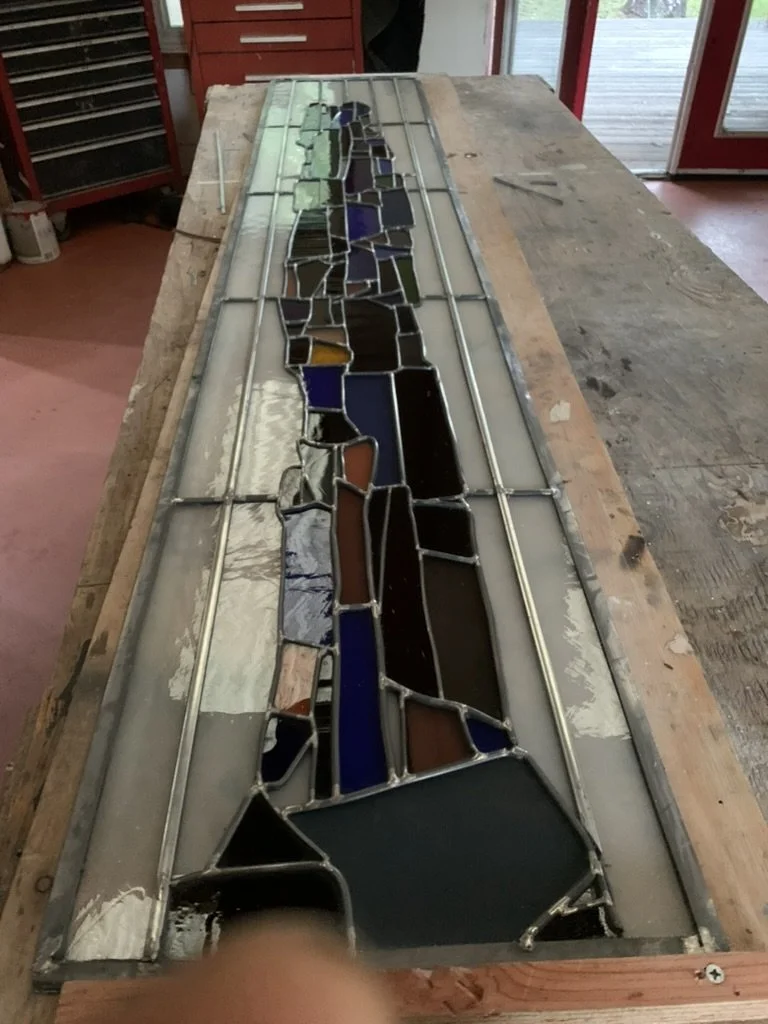

Second panel complete and crated ready for delivery

crated panel2.png
prev / next
Back to Beth El Project Journal
2
Beth El La Jolla Project Journal
3
January 3, 2026
6
January 6, 2026
5
January 7, 2026
5
January 8, 2026
4
January 10, 2026
3
January 14, 2026
7
January 15, 2026
9
January 16, 2026
5
January 17, 2026
2
January 20, 2026
7
January 21, 2026
3
January 22, 2026
3
January 23, 2026
4
January 28, 2026
